New Plastic Molding Part
Development Guide
From CAD concept to shipped products — a 10-step framework for injection molding success, with real-world timelines and expert tips.
Injection molding enables mass production of precision plastic parts once the initial molds are made. Successfully navigating this process requires understanding each phase — from locked 3D files to first-article validation and full production runs. This guide breaks it into 10 logical stages for predictable, high-quality outcomes.
Finalize Part Designs
The foundation of every injection molding project is a fully locked 3D CAD model. Before investing in steel tooling, ensure all critical dimensions are confirmed and DFM (Design for Manufacturing) compliance has been reviewed by experienced engineers. Mold flow simulation at this stage reveals moldability issues when changes are still inexpensive.
Focus initial design efforts on overall form factor and function — refine aesthetics after manufacturing constraints are understood. Outer contours and critical structural features should be prioritized first.
Prototyping Concept Parts
Even the most refined CAD model is theoretical until physically validated. Prototype concept parts via 3D printing or CNC machining before committing to full tooling. This tactile validation reveals form, fit, and ergonomic gaps that digital models miss.
Prototypes expose real-world gaps early — when design iterations are still cheap. Use feedback from physical samples to refine CAD files before mold fabrication begins.
Designing Injection Molds
With verified part geometry, engineers design the precision-machined steel tools that will form finished plastic parts. Critical details — surface finish, cavity count, cooling channel layout, ejector pin placement, and injection gate type — are all mapped at this stage.
World-class mold design minimizes cycle times and material waste while maximizing production quality and tool longevity. The goal is efficiency across the mold’s full production life, often hundreds of thousands of shots.
Analyze and Verify Tooling
Before any steel is cut, detailed mold flow simulation validates the design. Analysis checks cooling uniformity, fill-time balance, weld-line placement, injection pressure distribution, and potential sink marks — all at zero rework cost.
Everything from injection pressure balancing to texture plate integration is reviewed digitally first. This stage separates experienced mold makers from those who simply react to problems after machining.

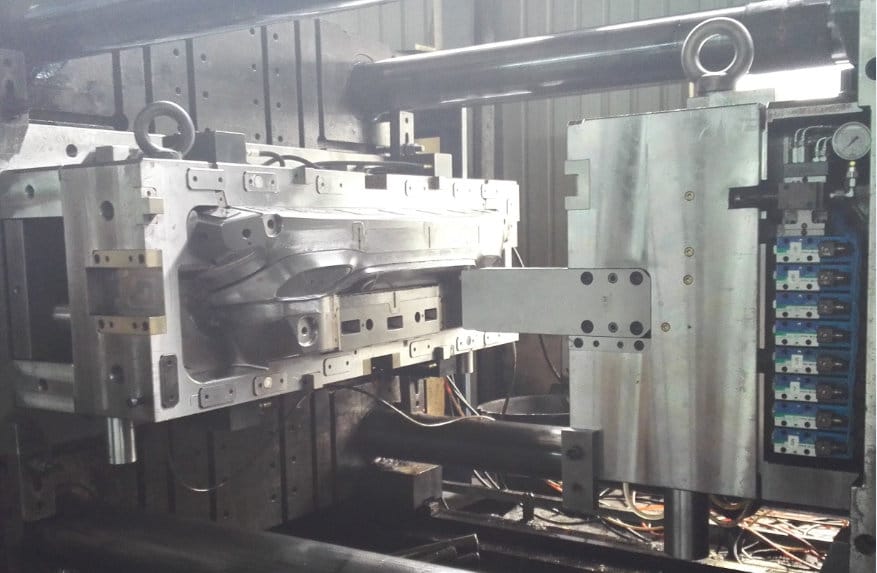

Fabricate Steel Molds
With an analyzed and approved design, machining begins. EDM and high-precision CNC milling convert virtual CAD data into physical steel tooling. Cavity geometries, ejector pin holes, cooling channels, and runner systems are all machined to tight tolerances.
Depending on part complexity and steel grade, mold fabrication typically takes 4–6 weeks. Rush options are available in 21 days for an additional fee.
First Article Sampling (T1)
Out of the machining center, the mold produces its first “T1” first article sample. Critical dimensions, surface finish, fill ratio, weld-line strength, warpage, and sink marks are all evaluated by hand or under a CMM (coordinate measuring machine).
T1 samples reveal details invisible in simulation. Sampling typically takes 1–2 weeks after tool completion. Client review and approval begins at this stage before any production commitment.
Optimize and Texture Molds
First shot samples rarely meet all specs out-of-the-box — this is expected and normal. Cooling layouts, vent positions, gate sizes, and runner balance are fine-tuned based on T1 feedback to stabilize fill, cycle time, and part quality.
Custom texturing procedures (matte, grain, gloss, leather-effect) are developed at this stage for the desired surface aesthetic.
Mass Production
Fully optimized and approved molds mark the transition from sampling to production. Parts are molded to T1-approved specifications with integrated quality control at defined inspection intervals.
For very high-volume or sensitive applications, exporting molds for in-house production is an option — preserving tooling security and giving direct production control. Define your production plan and volume forecast upfront.
Project Timelines
Planning realistic timelines prevents missed launches and supply chain disruptions. Use the detailed timeline reference below as a planning baseline. Complexity, material, and order quantity all influence actual lead times — always confirm specific schedules with your factory before committing to launch dates.
Communication & Alignment
Transforming concept CADs into shippable products depends on stakeholder alignment at every stage. Over-communicate design intent before tooling commitment. Define acceptance criteria for T1 sign-off, establish payment milestones, and align on production schedules early.
With open communication, expert guidance, and cross-functional commitment, injection molding projects run on time and on budget. Ambiguity is the root cause of most costly delays.
Use these benchmarks for project planning. All timelines are approximate and subject to part complexity and order volume.
| Phase | Standard | Rush | Notes |
|---|---|---|---|
| CAD Finalization & DFM Review | 1–2 wks | — | Client-driven; must be complete before deposit |
| Mold Fabrication | 5–6 wks | 21 days | Starts after deposit & approved 3D files |
| T1 First Article Sample | 1–2 wks | — | Complex parts may require additional time |
| Mold Optimization (if needed) | 1–2 wks | — | Depends on scope of required changes |
| Mass Production (10,000 units) | ~2 wks | — | Varies with material, complexity & quantity |
| Air Freight (samples / small qty) | 2–5 days | — | DHL / FedEx / UPS / TNT recommended |
| Ocean Freight | 20–45 days | — | Destination-dependent; FOB China port |
We support all major freight methods. If you have a designated forwarder, we can ship on your existing accounts.
